Pile Load Test Execution: Getting It Right from Setup to Failure

Good pile load test execution comes down to four disciplines: installing the test pile to match production conditions, building a stable and properly aligned testing setup, choosing the right loading procedure for what the test needs to prove, and reading instruments consistently at every increment. A sacrificial test pile can justify shorter or fewer production piles. Weak execution turns that same expensive test into a number nobody trusts.

Install the Test Pile the Way Production Piles Will Be Installed

Execution can go wrong before any load is applied. Installation method affects pile capacity, so a test pile driven or drilled with different equipment, at a different rate, or to a different termination criterion than the production piles will measure the wrong thing. Match the hammer, the rig, the installation sequence, and the acceptance criteria that production piling will use. Independent pile installation inspection is what confirms those conditions actually align.

Respect the setup period as well. Soil disturbed by installation regains strength over time, quickly in sands and over days or longer in clays. Testing too early typically understates capacity and hands the design a penalty it does not deserve, so the wait between installation and loading belongs in the schedule from the start.

Contact Nichols Environmental

Fusce dapibus, tellus ac cursus commodo, tortor mauris condimentum nibh, ut fermentum massa justo sit amet risus. Cras justo odio, dapibus ac facilisis in, egestas eget quam.

Contact Us

Build a Pile Testing Setup That Cannot Skew the Results

The physical setup determines whether the test data can be trusted, and two elements deserve the most scrutiny.

Reaction System Capacity and Clearance

The reaction system, whether kentledge, reaction piles, or ground anchors, must carry more than the maximum planned test load with margin to spare. Reaction elements also need enough clear distance from the test pile that their own load transfer does not influence the soil around it.

Alignment and Instrumentation

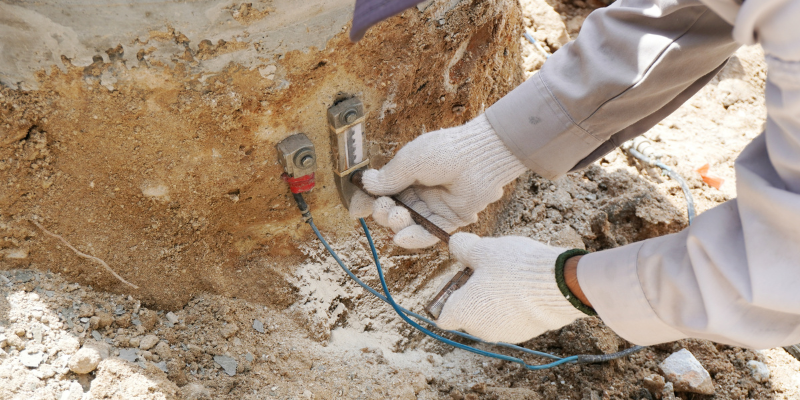

The jack, load cell, and bearing plates must sit concentric with the pile axis, because eccentric loading bends the pile, distorts the displacement readings, and can end the test early. Displacement instruments should mount on independent reference beams supported well away from the test pile and reaction system, so ground movement near the loaded elements cannot creep into the measurements. Record zero readings on every instrument before the first increment.

Choose the Loading Procedure Deliberately

ASTM D1143 recognizes several loading procedures, and the choice shapes what the data can tell you.

Quick Test

The Quick Test applies increments of five to ten percent of the expected failure load, targeting ten to twenty load steps, and typically wraps up in hours. For a sacrificial test, size those increments so the curve near failure has enough resolution to interpret. Coarse steps at the top of the curve waste the one chance to watch the pile approach its limit.

Maintained Test

The Maintained Test holds larger increments for longer intervals, which extends the test considerably and reveals more about creep settlement. The tradeoff is precision at the endpoint, since larger steps make the exact failure load harder to pin down.

Constant Rate of Penetration

The Constant Rate of Penetration method advances the pile at a steady rate while measuring the load required, which can produce the smoothest load-displacement curve and the sharpest definition of capacity. It is less common for large piles, where controlling the loading rate is more complicated.

Record Readings Immediately at Every Load Increment

Take movement readings immediately after each load increment and again before adding the next. Consistent, immediate readings do more than fill in the curve. They provide early warning that the reaction system is distressed, that the pile head is deteriorating, or that displacement is accelerating toward failure sooner than expected. A crew that only checks gauges at scheduled intervals can miss the moment that matters most.

ASTM is direct on this point: the quality of a static load test depends on the competence of the personnel running it and the suitability of the equipment. Qualified, experienced field staff are part of the test design, not an afterthought.

Execution Support from Nichols Environmental + Engineering

Nichols Environmental + Engineering supports deep foundation quality from investigation through construction. Our geotechnical engineering team carries out subsoil investigations and evaluates foundation strategies against measured soil properties, and our materials testing services confirm that deep foundation components meet specifications, safety requirements, and performance standards. That fieldwork is backed by accreditation with the Canadian Council of Independent Laboratories (CCIL) for civil and geotechnical materials testing.

If you are planning a test pile program in Western Canada and want the fieldwork inspected and verified with the same rigour that went into the design, contact us to talk through your project.
